Central Office

  • May 2022 Update

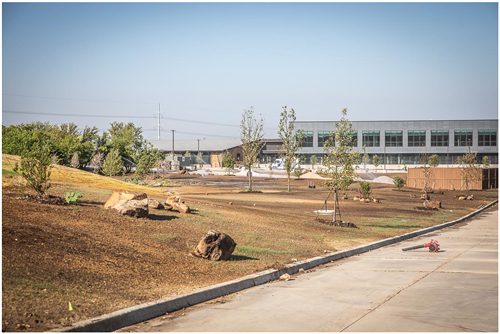

    • Retaining wall and planting

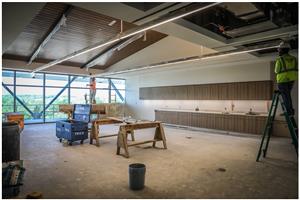

    • Lighting and ceiling in Area B

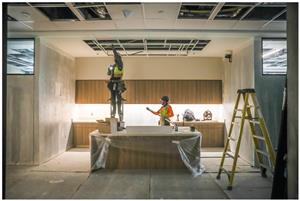

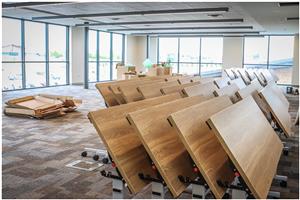

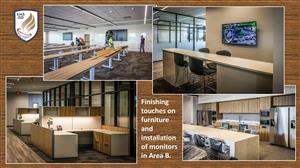

    • Work stations and mailroom in Area B

    April 2022 Update

    • Progress on the exterior finishes continue on schedule.

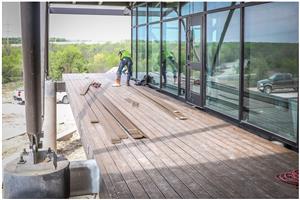

    • Exterior finishes continue and decking has begun on the balcony.

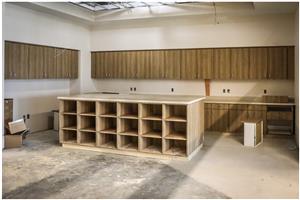

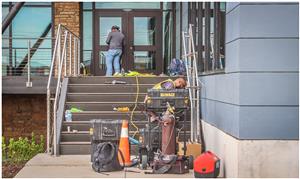

    • Millwork, lighting, and stairway handrails are in progress.

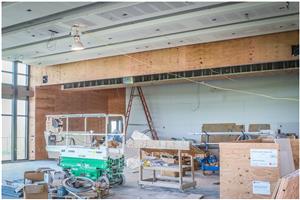

    • Ceiling finishes continue to progress in all areas of the building.

    March 2022 Update

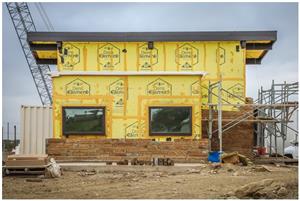

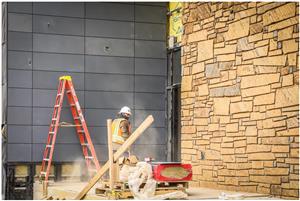

    • New Administration building exterior wall panels installation is in progress.
    • Installation of  ceiling grids in  all sections of  the building is in progress.

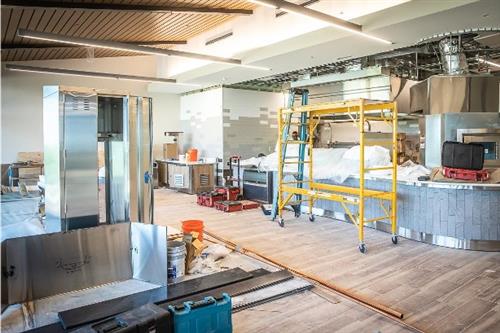

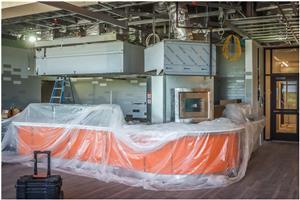

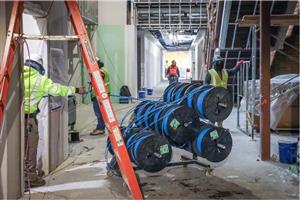

    • Bistro equipment installation is in  progress. Technology cable wire is being  pulled throughout the building.

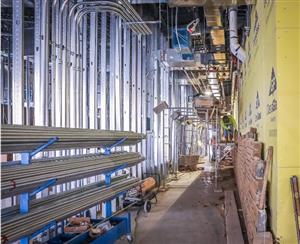

    • Rock wall work is nearing completion

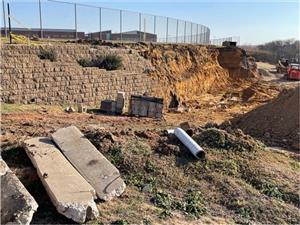

    • Chisholm Trail HS baseball retaining wall repair is in progress.
    • Eagle Mountain High School:
    • Core Construction has mobilized on the site.
    • Construction entrances have been installed.
    • Fencing has been installed for erosion control.
    • Grading permit is in progress with the City of Fort Worth.

    February 2022 Update

    • Final landscape grade is in progress around the west and south sides of the building.
    • Metal roof is near completion in Areas A, B, and C.
    • Glass framing is being installed in Area C.

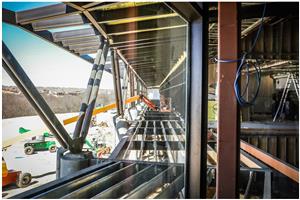

    • Construction of the back walkway is in progress. Mechanical duct work is being installed in Area C.

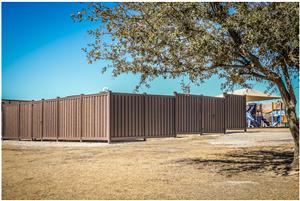

    • New fencing is complete around well fixtures at Eagle Mountain ES and Elkins ES.

    January 2022 Update

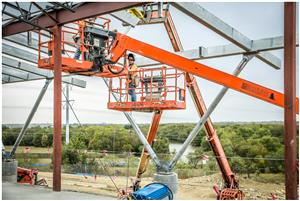

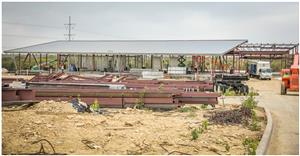

    • The deck is installed, foundation poured, and iron work for roof is ongoing in Area A.

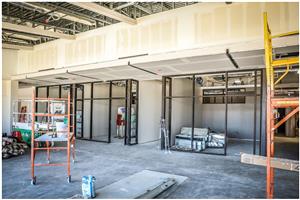

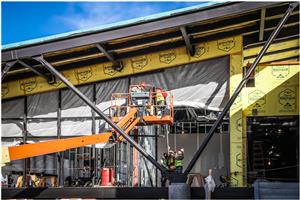

    • Glass frames and glass are being installed in the Absher area. Rock and sheetrock continue on the back of the building.

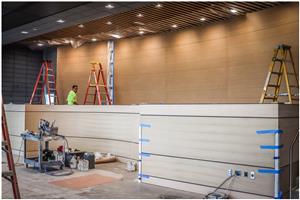

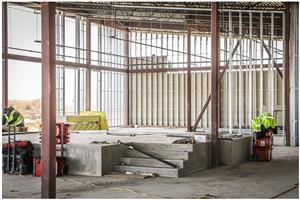

    • Board room dais structure has been poured. Framing and sheetrock continue in the Ramsey area.

    December 2021 Update

    • The deck is installed, foundation poured, and iron work for roof is ongoing in Area A.

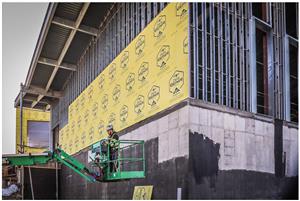

    • Exterior sheathing, framing, roof installation, and fire sprinkler installation continues in Area B.

    November 2021 Update

    • In Area B, the second-floor deck is being completed. The stairs have been installed to the second floor, and the iron work continues in this area.

    • In Area C, the exterior sheathing, rock work, interior wall framing, and rough-in electrical continues.

    October 2021 Update

    • Iron work continues. Exterior and interior framing in Area C is progressing. Mock up is 60% complete.
    • Work continues on the installation of the pipe for the fire system, roof framing, and concrete blocks on the lower level.

    September 2021 Update

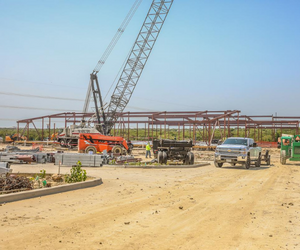

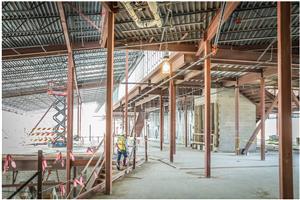

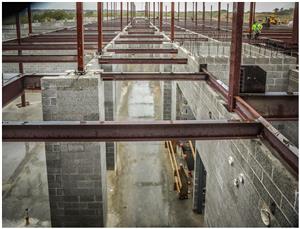

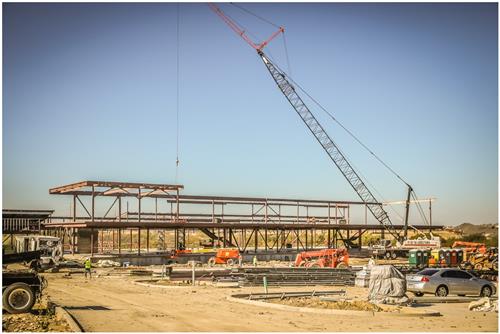

    • The steel structure installation over the Finance, Superintendent, and Operations suites is being installed.

    August 2021 Update

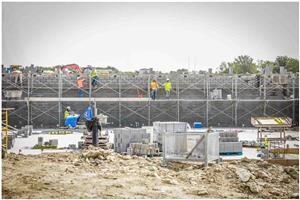

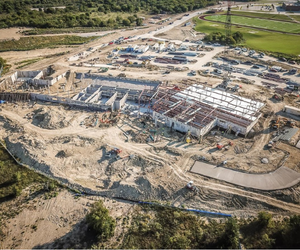

    • Concrete Masonry Unit walls continue to be built in lower level

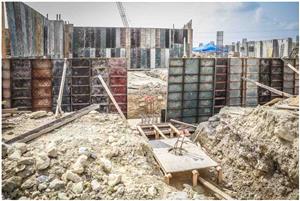

    • Exterior walls and grade beam construction continues on the north side of the building

    July 2021 Update

    • The CMU block is being utilized to form up the walls on the lower level. Rebar is in place to pour the main entrance to the building.

    June 2021 Update

    • The northern parking lot pour has been completed
    • Site work delayed due to rain
    • Eastern walls in the business area are being formed for future concrete pour

    April 2021 Update

    • Piers are in the process of being drilled. They are filled with rebar and concrete, and 180 of the 300-plus piers have been completed.

    March 2021 Update

    • The parking lot is being excavated and soil relocated on site.

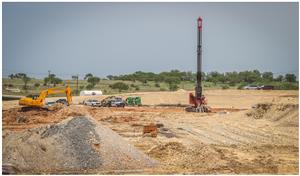

    • The building site is being excavated and prepped for piers.

    February 2021 Update

    • Construction trailer has been set in place with electricity and data. The security, silt, and tree fencing are complete.

    December 2020 Update

    • Naming the general contractor is an action item for Board consideration at the December meeting.

    November 2020 Update

    • Competitive sealed proposal has been released for bidding. Project will come to the Board for consideration in December for the naming of the general contractor. CSP is out for bid. A pre-construction meeting was held last week to answer questions about the project.

    October 2020 Update

    • The competitive Sealed proposal has been released for bidding. The project will come to the Board for consideration in December 2020 for the naming of the general contractor.

    September 2020 Update

    • Still in final review, competitive sealed proposal (CSP) will be recommended as the procurement method.

    August 2020 Update

    • Still in final review, competitive sealed proposal (CSP) will be recommended as the procurement method.

    July 2020 Update

    • Reviewing final finishes

    June 2020 Update

    • Site visit to pin the building corners down. Reviewing final finishes

     May 2020 Update

    • Continued design meetings. Projected construction will begin in Fall 2020.

    April 2020 Update

    • Continue design meetings. Projected construction will begin in Fall 2020.
  • May 23, 2022

  • April 25, 2022

  • March 2022

  • February 2022

  • January 2022

  • December 2021

  • November 2021

  • October 2021

  • September 2021

  • August 2021

  • July 2021

  • June 2021

  • April 2021

  • March 2021

  • February 2021
